West Valley Projects
Construction projects and progress.
Facilities Master Plan
Version: 2020
Facilities Master Plan
Version: 2020
Construction Updates | October 2026
At-a-Glance
| Construction Estimate Amount | $500,000.00 |
| Project Phase | Design |
| Percent Complete | 99% |
| Funding | Measure W |
| Total Change Order Amount | $0 |
| Percent of Approved Change Orders | 0% |
Schedule Milestones
| Design Phase | December 2025 | June 2026 |
| DSA Review & Approval | July 2026 | TBD |
| Bidding | December 2026 | February 2027 |
| Construction | June 2026 | TBD |
| Closeout | TBD |
Key Contracts
| Architect | Salas O’Brien |
| Contractor | TBD |
| Construction Manager | Kitchell |
Project Description

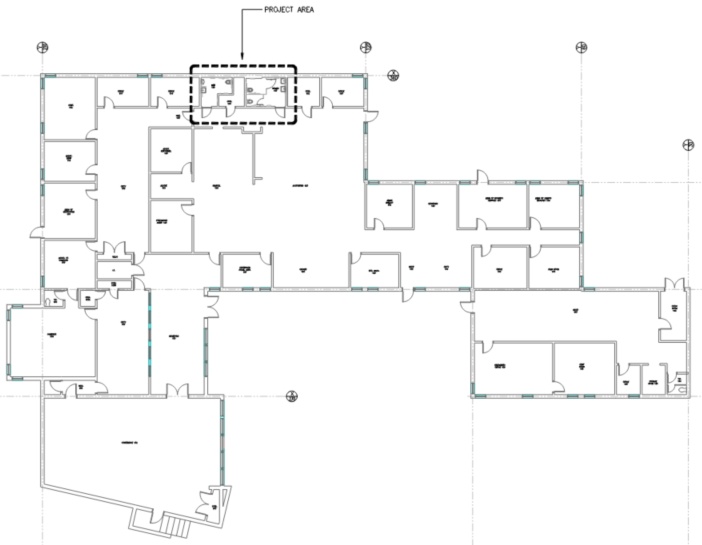

The project will upgrade the Administration building’s main restrooms.
Past Month’s Accomplishments
- The Division of State Architect (DSA) has issued design comments as part of the original submission.
- Salas O’Brien has responded to the comments issued by DSA and resubmitted the design documents.
Next Month’s Milestones
- Review and address DSA comments.
Cost/ Scope/ Timeline Changes
- N/A

At-a-Glance
| Construction Estimate Amount | $3,400,000.00 |
| Project Phase | Design |
| Percent Complete | 85% |
| Funding | CIF |
| Total Change Order Amount | $0 |
| Percent of Approved Change Orders | 0% |
Schedule Milestones
| Design Phase | May 2025 | November 2025 |
| DSA Review & Approval | November 2025 | August 2026 |
| Construction | December 2026 | June 2027 |
| Bidding | January 2027 | April 2027 |
| Submittals and Procurement | April 2027 | November 2027 |
| Construction | December 2027 | June 2028 |
| Closeout | July 2028 |
Key Contracts
| Architect | Steinberg Hart |
| Construction Manager | Kitchell |
Project Description

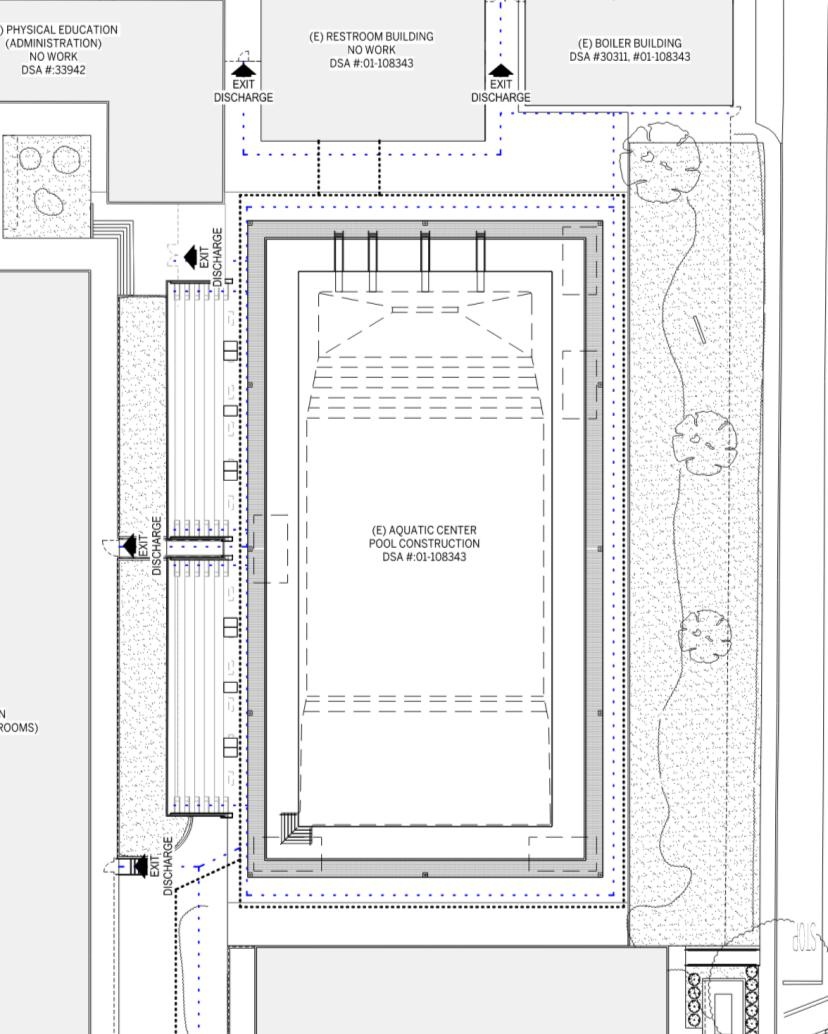

The project will upgrade and repair the existing aquatics center.
Past Month’s Accomplishments
- The Division of State Architect (DSA) issued the official approval of design documents.
Next Month’s Milestones
- Initiate Santa Clara County Department of Environmental Health plan check review of DSA approved documents.
Cost/ Scope/ Timeline Changes
- N/A

At-a-Glance
| Construction Estimate Amount | $7,300,000.00 |
| Project Phase | Design |
| Percent Complete | 0% |
| Funding | Measure W |
| Total Change Order Amount | $0 |
| Percent of Approved Change Orders | 0% |
Schedule Milestones
| Design Phase | January 2027 | June 2027 |
| DSA Approval | August 2027 | March 2028 |
| Construction | TBD |
| Closeout | TBD |
| Move-in | TBD |
Key Contracts
| Architect | Aedis Architects |
| Contractor | TBD |
| Construction Manager | Kitchell |
Project Description
The project will renovate a newly acquired building to become the new home for the Child Development Center (CDC).
Past Month’s Accomplishments
- Structural testing occurred at the new building. Test to determine whether building should be demolished for a replacement or continue with renovations.
Next Month’s Milestones
- Continue to finalize design of building.
Cost/ Scope/ Timeline Changes
- N/A

At-a-Glance
| Construction Estimate Amount | $5,000,000.00 |
| Project Phase | Design |
| Percent Complete | 95% |
| Funding | Measure W and CIF |
| Total Change Order Amount | $0 |
| Percent of Approved Change Orders | 0% |
Schedule Milestones
| Design Phase | March 2025 | January 2026 |
| DSA Review | January 2026 | October 2026 |
| Construction | May 2027 | August 2027 |
| Closeout | August 2027 | September 2027 |
Key Contracts
| Architect | HPI |
| Construction Manager | Kitchell |
Project Description
The project will landscape the area around the Science and Math building and demolish the Old Planetarium and Giurlani House.
Past Month’s Accomplishments
- Board of Trustees awarded a contract to Penkor Wrecking to demo old planetarium and Giurlani House.
Next Month’s Milestones
- Contract should be finalized in November so work can begin in December.
Cost/ Scope/ Timeline Changes
- Landscaping at the Giurlani House and Old Planetarium was added to the scope.
- Contract award was pushed from Sept board to Oct board.

At-a-Glance
| Original Base Contract Amount | $102,023,483 |
| Project Phase | Design/Construction |
| Percent Complete | 31% |
| Funding | Measure W and Capital Imp. Funds (CIF) |
| Total Change Order Amount | $0 |
| Percent of Approved Change Orders | 0% |
Schedule Milestones
| Design Phase | September 2024 | June 2026 |
| DSA Review | December 2025 | August 2026 |
| Construction | August 2026 | September 2028 |
| Closeout | October 2028 | November 2028 |
| Move-in | October 2028 |
Project Budget
| Initial | $125,753,341 |
| Current Board of Trustees Approved | $102,023,483 |
Key Contracts
| Design Build Entity (DBE) | Hensel Phelps & Cannon |
| Construction Manager | Kitchell |
Project Description
Construct a new Wellness Center to support the athletics programs on campus with community spaces for public use.
Past Month’s Accomplishments
- Off-haul of existing utility storm drain and electrical duct bank complete
- Grading activities ongoing
Next Month’s Milestones
- Repaving of pathway from Lot 5 to PE Complex
- Remaining off-haul of track material and asphalt
Cost/Scope/Timeline Changes
- N/A
At-a-Glance
| Construction Estimate Amount | $500,000.00 |
| Project Phase | Bidding |
| Percent Complete | 5% |
| Funding | Measure W |
| Total Change Order Amount | $0 |
| Percent of Approved Change Orders | 0% |
Schedule Milestones
| Design Phase | December 2025 | June 2026 |
| Bidding | October 2026 | TBD |
| Procurement/Construction | TBD | TBD |
| Closeout | TBD |
Key Contracts
| Architect | Salas O’Brien |
| Contractor | TBD |
| Construction Manager | Kitchell |
Project Description

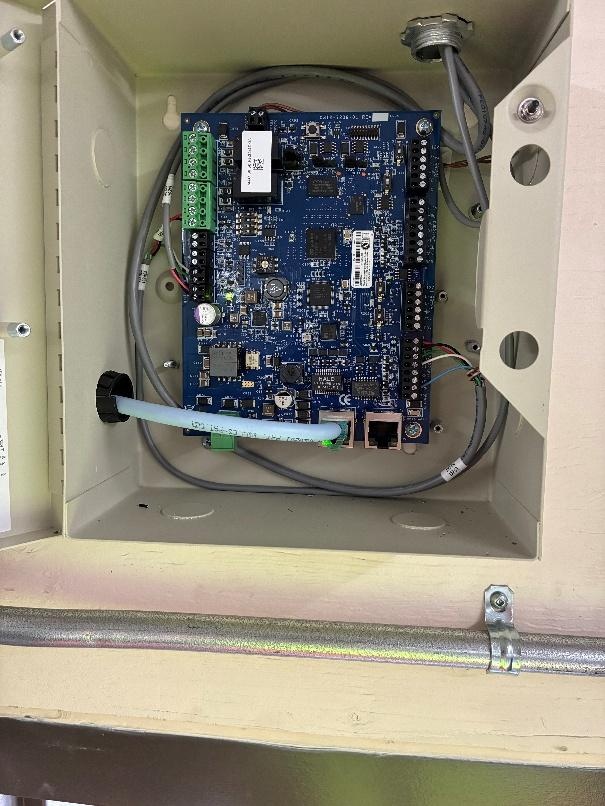

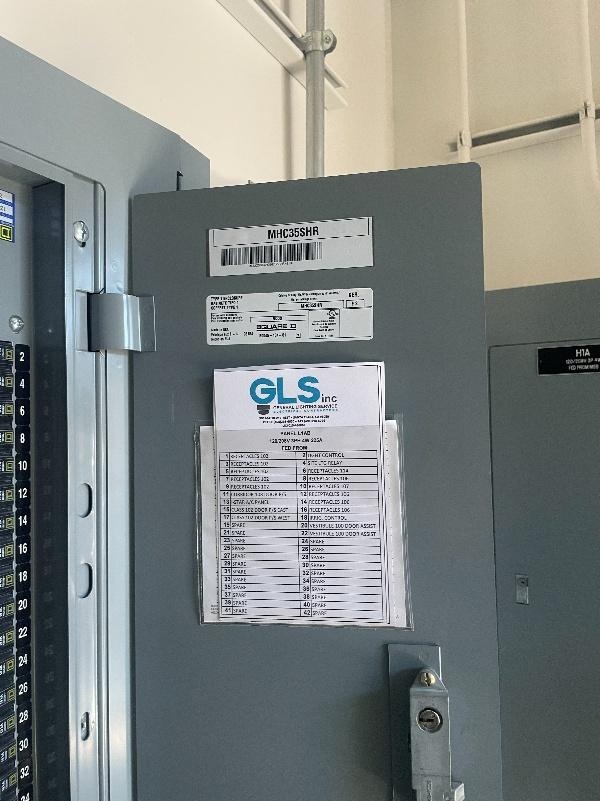

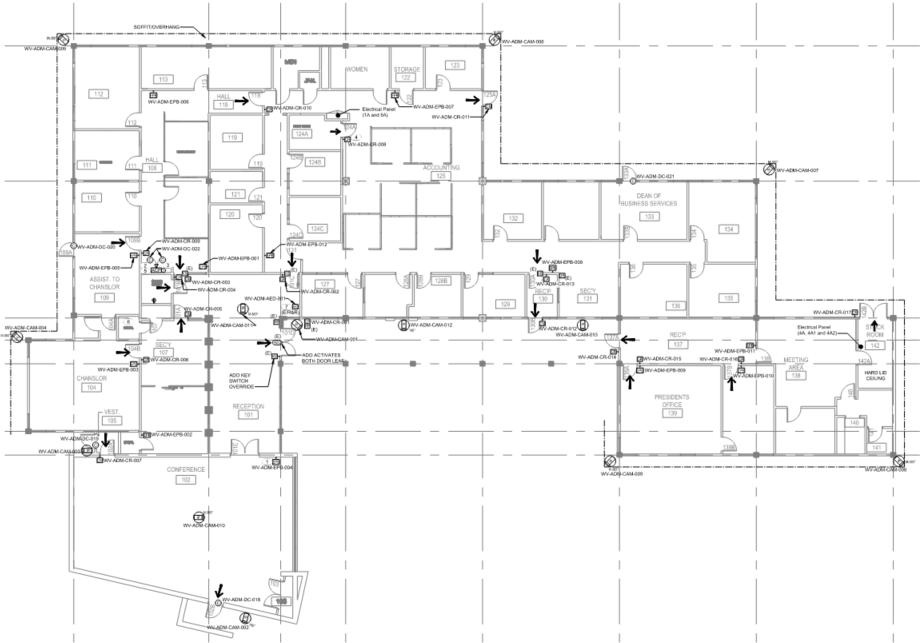

The project will upgrade the Administration building’s security systems.
Past Month’s Accomplishments
- Design documents are complete for the project.
Next Month’s Milestones
- Various security projects at Mission College and West Valley College will be packaged together as one district wide project to be bid.
Cost/ Scope/ Timeline Changes
- N/A

At-a-Glance
| Construction Estimate Amount | $432,380 |
| Project Phase | Construction |
| Percent Complete | 13% |
| Funding | Insurance |
| Total Change Order Amount | $0 |
| Percent of Approved Change Orders | 0% |
Schedule Milestones
| Design Phase | October 2025 | April 2026 |
| DSA Approval | N/A |
| Construction | September 2026 | December 2026 |
| Closeout | December 2026 |
Project Budget
| >Initial | $758,853 |
| Current Approved | $432,380 |
Key Contracts
| Architect | SGH Architects |
| Contractor | Rainbow Waterproofing & Restoration Co. |
| Construction Manager | Kitchell |
Project Description
The project will provide maintenance to restore the exterior envelope at the Facilities Building due to water intrusion issues.
Past Month’s Accomplishments
- Mock-ups and adhesion testing ongoing.
- Grinding/cutting out mortar joints, injecting epoxy, pressure washing ongoing
Next Month’s Milestones
- Patching cracks and installing new sealant
Cost/Scope/Timeline Changes
- N/A
At-a-Glance
| Construction Estimate Amount | $380,970 |
| Project Phase | Construction |
| Percent Complete | 11% |
| Funding | CIF |
| Total Change Order Amount | $0 |
| Percent of Approved Change Orders | 0% |
Schedule Milestones
| Design Phase | October 2025 | April 2026 |
| DSA Approval | N/A |
| Construction | September 2026 | December 2026 |
| Closeout | December 2026 |
Project Budget
| Initial | $755,194 |
| Current Approved | $380,970 |
Key Contracts
| Architect | SGH Architects |
| Contractor | Rainbow Waterproofing & Restoration Co |
| Project Manager | Kitchell |
Project Description
Provide elastomeric paint sealant to restore the exterior walls at the Information Systems Building due to water intrusion issues.
Past Month’s Accomplishments
- Mock-ups, water testing and adhesion testing ongoing.
- Stucco crack repair ongoing
- Window perimeter sealant and wet seal ongoing.
Next Month’s Milestones
- • Complete surface preparations prior to full building elastomeric coating.
Cost/Scope/Timeline Changes
- Specified color is not as dark as originally intended, contractor is exploring different color options to achieve higher contrast.
At-a-Glance
| Construction Contract Amount | $1,278,000.00 |
| Project Phase | Construction |
| Percent Complete | 90% |
| Funding | Measure W |
| Total Change Order Amount | $0 |
| Percent of Approved Change Orders | 0% |
Schedule Milestones
| Design Completion | January 2025 | August 2025 |
| DSA Approval | January 2025 | April 2025 |
| Construction | April 2026 | November 2026 |
| Closeout | November 2026 | December 2026 |
Project Budget
| Initial | $1,278,000.00 |
| Current Approved | $1,278,000.00 |
Key Contracts
| Architect | P2S |
| Contractor | ESI |
| Construction Manager | Kitchell |
Project Description

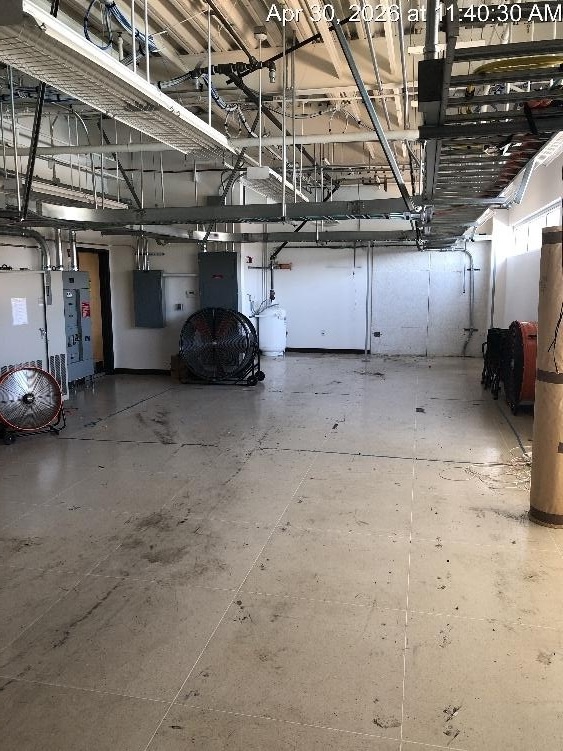

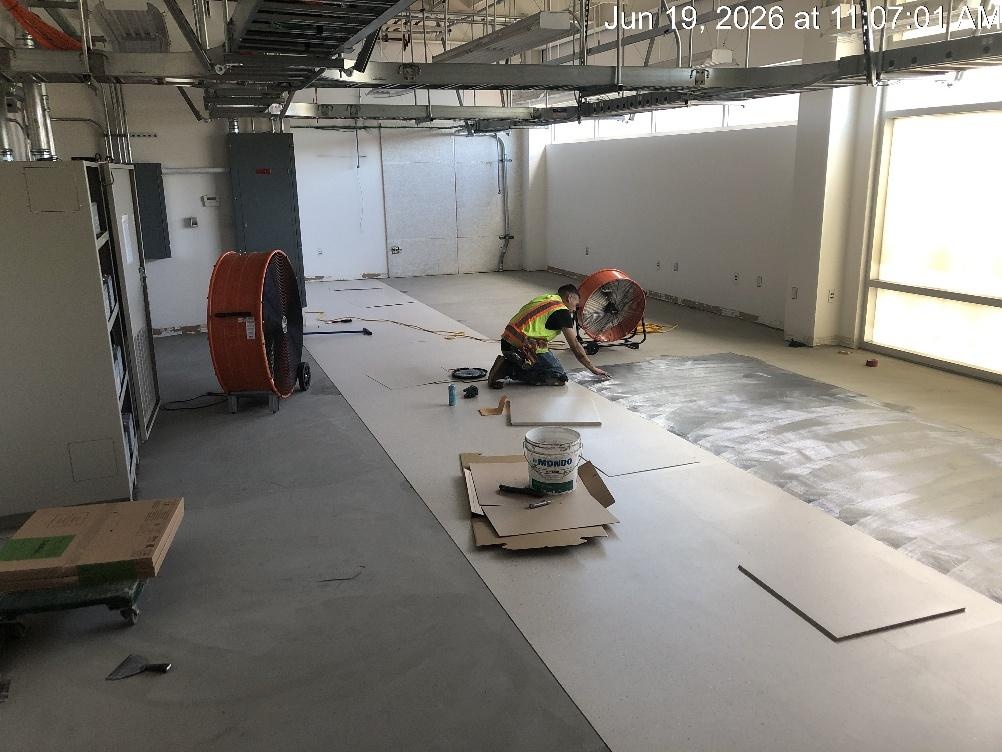

The project will install a new cooling system and server racks with supporting infrastructure in the Information Systems (IS) Building data center.
Past Month’s Accomplishments
- Walls have been patched and painted
- All piping and conduit infrastructure complete
- Start-up, testing, adjusting, and balancing ongoing
Next Month’s Milestones
- Controls integration complete
- All commissioning activities complete
- Punchlist and closeout ongoing
Cost/Scope/Timeline Changes
- Existing lights will need to be relocated, currently up against new busway.
At-a-Glance
| Construction Contract Amount | $67,160,000 |
| Project Phase | Construction |
| Percent Complete | 22% |
| Funding | Measure W and State Funds |
| Total Change Order Amount | $0 |
| Percent of Approved Change Orders | 0% |
Schedule Milestones
| Design Phase | January 2022 | March 2024 |
| DSA Review | March 2024 | March 2025 |
| Bidding | September 2025 | December 2025 |
| Construction | March 2026 | January 2028 |
| Closeout | February 2028 | May 2028 |
| User Move-in | July 2028 | August 2028 |
Project Budget
| Initial | $51,273,700 |
| Current Approved | $74,768,351 |
Key Contracts
| Engineer | DLR Group |
| Contractor | Thompson Builders |
| Construction Manager | Kitchell |
Project Description:
The project demolishes the old Music Building and replaces it with a new one; the Theater Building Renovation and New Black Box Theater addition.
Past Month’s Accomplishments

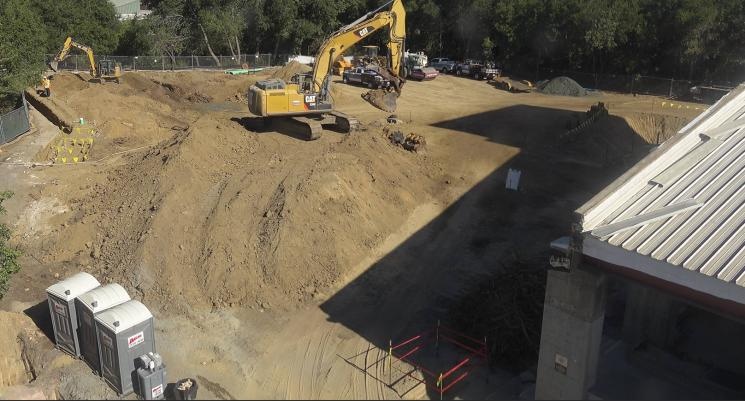

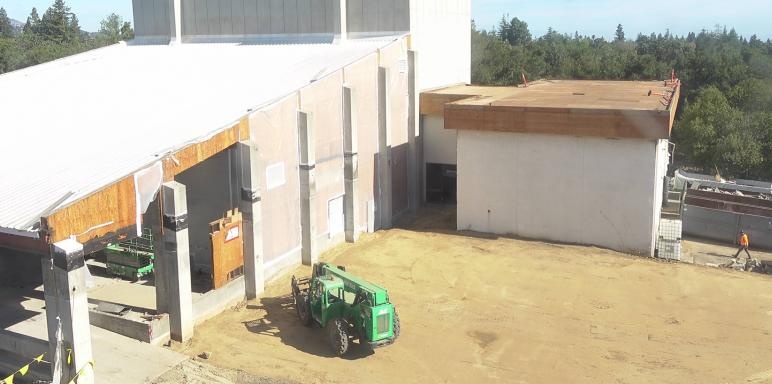

- Footing concrete began to be poured for the Music Building
- Concrete started to be placed for the new basement walls
- Under slab plumbing was installed at the basement
- Structural upgrades in the basement began
Next Month’s Milestones
- Concrete for footings and walls will be completed
Cost/Scope/Timeline Changes
- N/A
At-a-Glance
| Construction Contract Amount | $1,495,000.00 |
| Project Phase | Construction |
| Percent Complete | 95% |
| Funding | Measure W |
| Total Change Order Amount | $0 |
| Percent of Approved Change Orders | 0% |
Schedule Milestones
| Design Phase | January 2026 | February 2026 |
| DSA Approval | N/A |
| Construction | June 2026 | October 2026 |
| Closeout | November 2026 | December 2026 |
| Move-in | November 2026 |
Project Budget
| Initial | $1,495,000.00 |
| Current Approved | $1,495,000.00 |
Key Contracts
| Architect | Garland |
| Contractor | Courtney, Inc. |
| Construction Manager | Kitchell & Gilbane |
Project Description

The project will provide roof restoration, patch and repair at both the West Valley College campus and Mission College campus.
Past Month’s Accomplishments

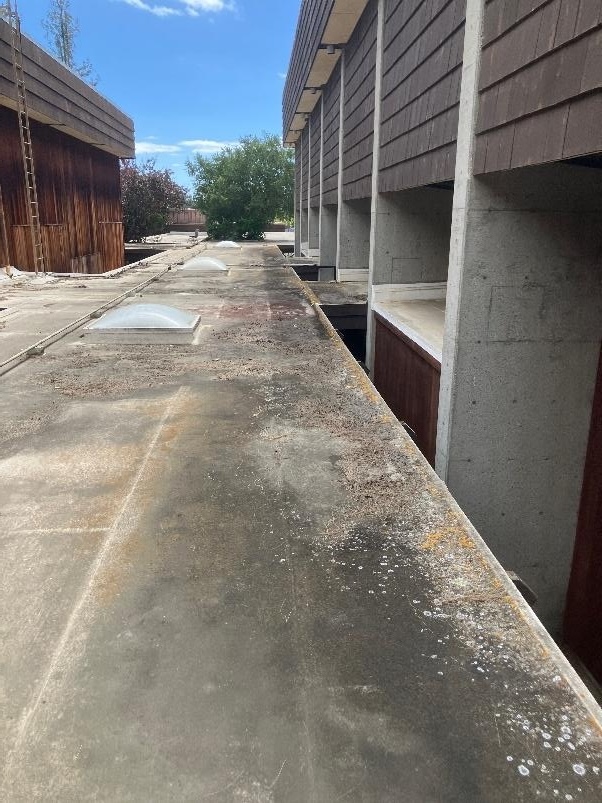

- PE Complex and Campus Center roof restoration work was completed.
- Punch walks for both buildings were completed and addressed.
Next Month’s Milestones
- Begin contract closeout.
Cost/Scope/Timeline Changes
- N/A
At-a-Glance
| Construction Estimate Amount | $2,000,000 |
| Project Phase | Bidding |
| Percent Complete | 95% |
| Funding | Measure W |
| Total Change Order Amount | $0 |
| Percent of Approved Change Orders | 0% |
Schedule Milestones
| Design Phase | May 2025 | September 2025 |
| DSA Approval | September 2025 | March 2026 |
| Bidding | March 2026 | September 2026 |
| Procurement | September 2026 | February 2026 |
| Construction | December 2026 | May 2027 |
| Closeout | June 2027 |
Project Budget
| Initial | $2,083,876.00 |
| Current Approved | $2,083,876.00 |
Key Contracts
| Engineer | P2S |
| Contractor | Mesa Energy Systems |
| Construction Manager | Kitchell |
Project Description

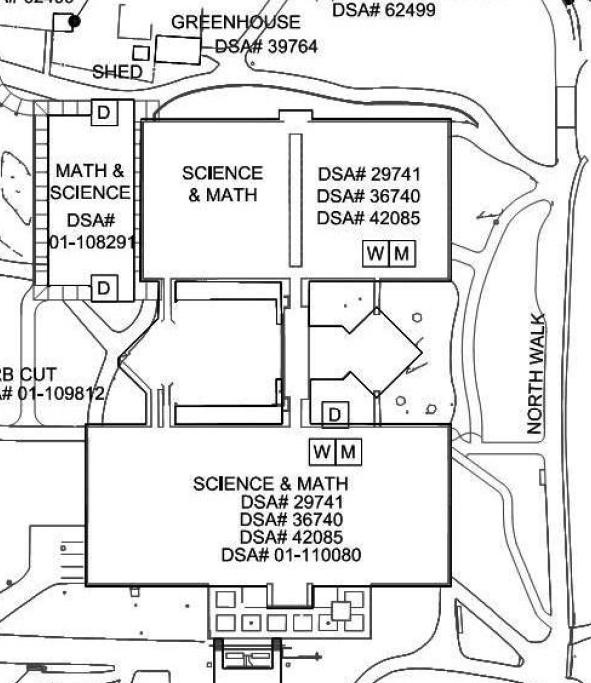

The project will improve ventilation, heating, and cooling systems in the Science and Math Building.
Past Month’s Accomplishments
- The project has been set up on Procore and Mesa Energy Systems has begun uploading submittals for review.
Next Month’s Milestones
- Begin procurement process for long lead time items.
Cost/Scope/Timeline Changes
- N/A

At-a-Glance
| Original Base Contract Amount | $59,234,092 |
| Project Phase | Closeout |
| Percent Complete | 99% |
| Funding | Measure C, Measure W, State Funds |
| Total Change Order Amount | $5,298,506 |
| Percent of Approved Change Orders | 12.56% |
Schedule Milestones
| Design | February 2020 | February 2021 |
| DSA Approval | March 2021 | January 2022 |
| BOT Approval | September 2022 | October 2022 |
| Construction | January 2023 | January 2026 |
| Closeout | June 2025 | June 2026 |
| Move-in | January 2026 |
Project Budget
| Initial | $22,531,000 |
| Current Approved | $73,196,219 |
Key Contracts
| Architect | ABA/MCA |
| Contractor | Swinerton |
| Project Manager | Kitchell |
Project Description
Renovation of the existing Library to create a modern Learning Resource Commons upgrading major building systems.
Past Month’s Accomplishments
- Notice of Completion (NOC) filed with the Santa Clara County Clerk-Recorder’s Office.
Next Month’s Milestones
- Project closeout documentation to be submitted by the contractor.
Cost/Scope/Timeline Changes
- N/A
